03 / Selected work

The work behind the numbers.

Seven write-ups: what the situation was, what I did, what changed, and why it matters. Two of them are real roles; the rest are master's work I chose to treat like client engagements.

CASE / 01IBT Education

IBT Education - Correlation ≠ Causation

My roleAcademic Program Coordinator
TeamIndividual analysis, raised unprompted
TimelineMar - Dec 2024, IBT Education
TypeProfessional work
59%
Band 7 attainment
Up from 27%, same cohort
8.5 vs 4
Students per tutor, languages vs others
1 in 10
Finished band 5 or below
Down from 1 in 3
At a glance
Context

As Academic Program Coordinator at IBT Education, I owned student-outcome analysis across 50+ IB subjects. I was also tutoring four of them myself at the time, including Spanish, where I was the company's first tutor.

What I did

The signal came from Spanish, a subject I know deeply, so weak results there didn't sit right. I pulled the outcome data across cohorts and found the same shape in the language subjects: the problem tracked with tutor-to-student ratios, not student ability. Spanish and French were carrying around 8.5 students per tutor against roughly 4 elsewhere (Fig. 1.1). I wrote it up for management with a specific fix: reallocate two tutors to the stretched language subjects, refresh their materials, and add subject-specific tutor guides.

Result

Management implemented the changes. For that same cohort, top-band (band 7) attainment across Spanish and French rose from 27% at their mid-year trial exams to 59% at their November finals, and the share finishing at band 5 or below fell from about a third to roughly one in ten. The one-off analysis became a recurring, program-wide data-review process.

Why it matters

It's how I work everywhere: notice what doesn't fit, ask why before deciding what to do, and let the data point to the real lever, then hand back something a team can act on.

Next case / 02 ANZ - Building accuracy from disparity One structured reference set, built in a regulated bank, that outlived me
CASE / 02ANZ

ANZ - Building accuracy from disparity

My roleSmall Business Consultant
TeamBuilt solo, adopted across the team
TimelineMay 2025 - Feb 2026, ANZ
TypeProfessional work
50%
Throughput gain
vs the 30-case benchmark
45+
Cases resolved / day
Peaking at 60
Lowest
Escalation rate on the team
At a glance

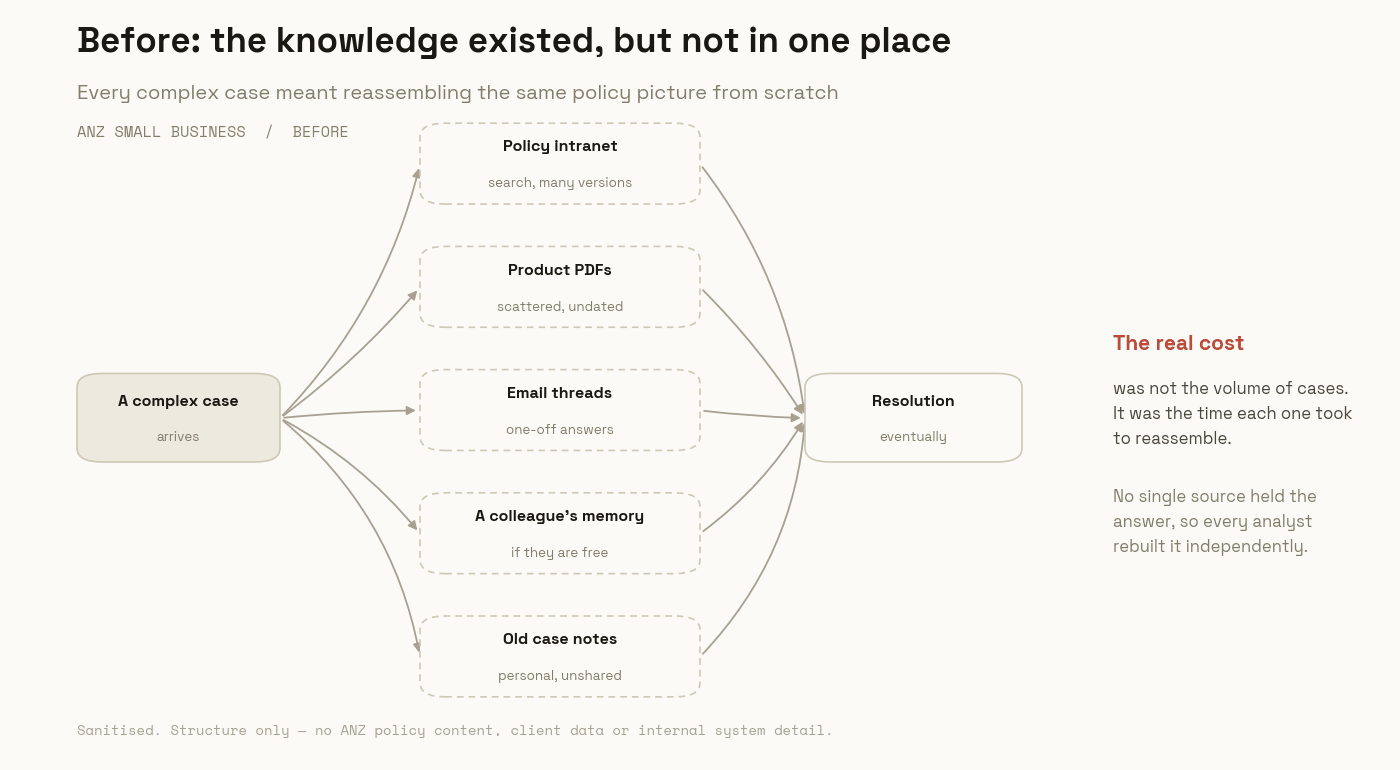

The policy and process reference set: one structured source routing a case to a compliant resolution Before: policy knowledge scattered across an intranet, PDFs, email threads, colleagues and personal notes FIG. 2.1Interactive The reference set replaced the reassembly. Structure only, sanitised: no ANZ policy content, client data or internal system detail.
Context

At ANZ I resolved small-business client cases in a regulated banking environment, where every resolution has to be correct, compliant, and defensible on audit. Four months in, KPI targets rose from a 30-case daily benchmark toward 45+. The volume wasn't the real problem - the real cost was the time each case took, because the policy and process knowledge needed to resolve them lived in people's heads and across scattered sources.

What I did

I treated it as an analysis problem before a speed problem. I mapped where handling time actually went, then built a working reference set of policy and process notes (Fig. 2.1), a single, structured source that standardised how complex scenarios got resolved and sharpened which cases to prioritise. I kept the documentation audit-ready and engaged cross-functional stakeholders to align on compliant resolutions, so the reference set held up under governance, not just at my own desk.

Result

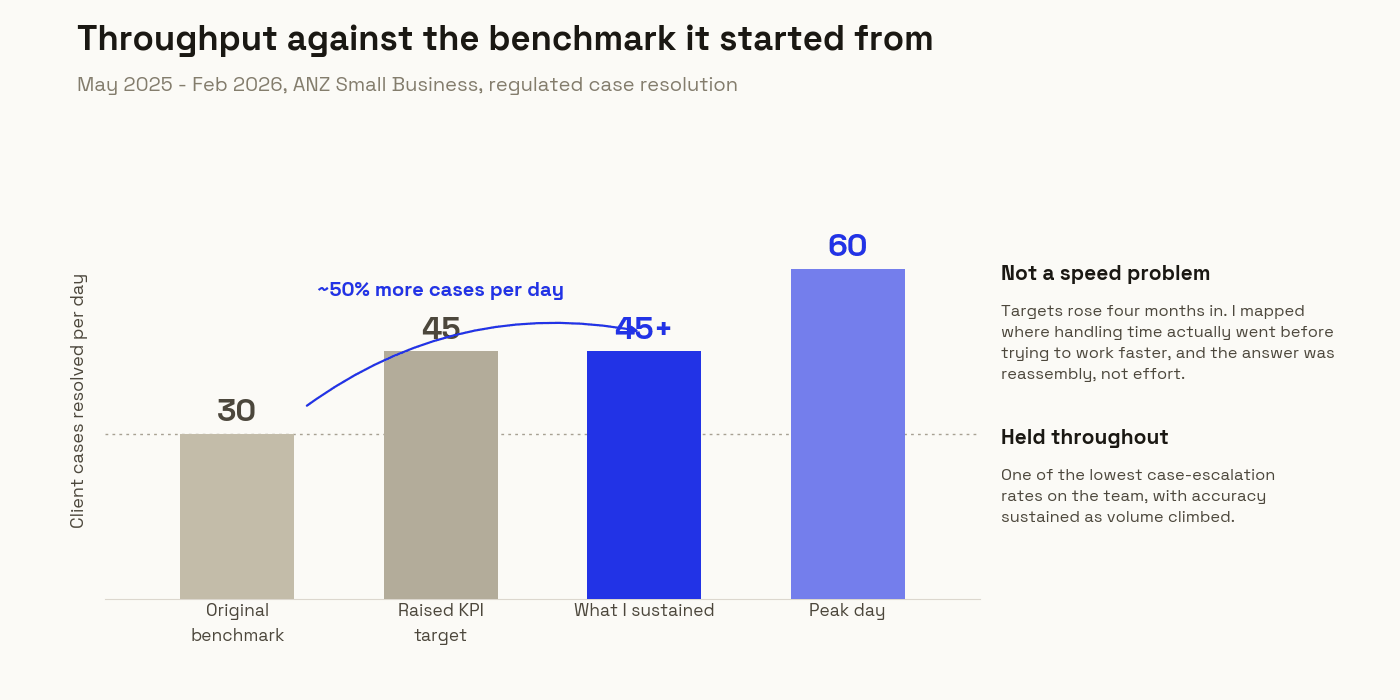

Per-case handling time fell and throughput rose to 45+ cases a day, peaking at 60, roughly a 50% increase on the original benchmark, while I held one of the lowest case-escalation rates on the team and sustained accuracy as volume climbed. The reference set became shared infrastructure: structured documentation that supported knowledge transfer across the team, not a personal shortcut.

Why it matters

This is the PMO half of how I work. Finding the real lever is step one; the value is in turning it into a repeatable system with the governance, documentation, and stakeholder alignment that lets other people rely on it. Process improvement that survives an audit and outlives the person who built it.

Next case / 03 Melbourne LXRP: Noble Park - Ignoble Management Did engagement shape decisions, or just document them?
CASE / 03

Melbourne LXRP: Noble Park - Ignoble Management

My roleOverall direction and research design; structure, layout and supervisor liaison
TeamTwo-person group (Group 24). My partner, a practising project engineer, led the in-depth industry research
TimelineSemester 1, 2026 - 9,866 words
TypeMaster's coursework, treated as a client engagement
$1.6B
Caulfield–Dandenong LXRP
17%
Rail users aware of engagement
5
Recommendations delivered
At a glance
Context

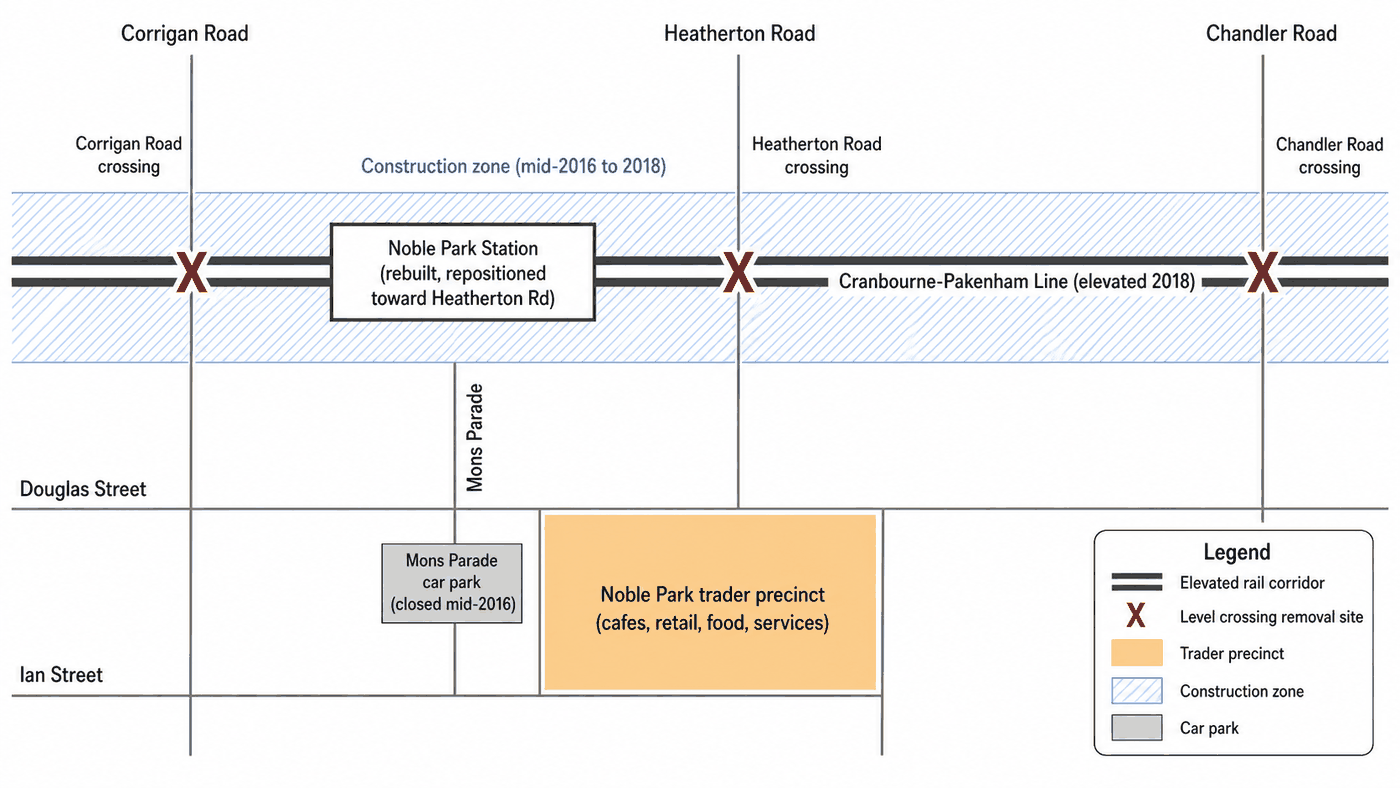

A 9,866-word group investigation for BUSM4415 (Industry Project Investigation) into stakeholder engagement on the $1.6B Caulfield to Dandenong Level Crossing Removal Project, focused on construction disruption for traders in Noble Park's Douglas & Ian Street precinct between 2016 and 2018.

What I did

I built a desk-based case study around one question: did engagement actually shape how disruption was managed, or mainly justify decisions already made? I tested it against three independent sources: the Victorian Auditor-General's audit, a pre-construction survey of 144 traders, and the minutes of the local community liaison groups.

Result

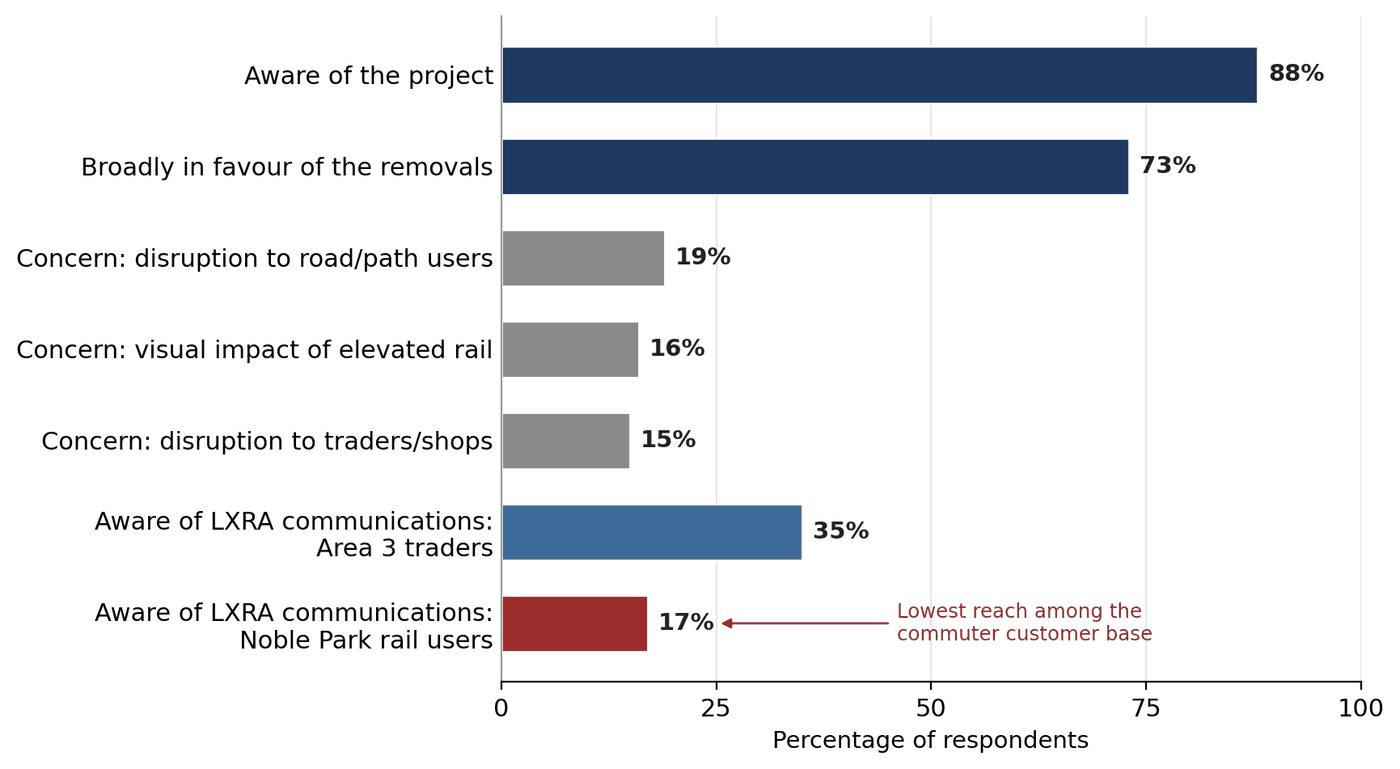

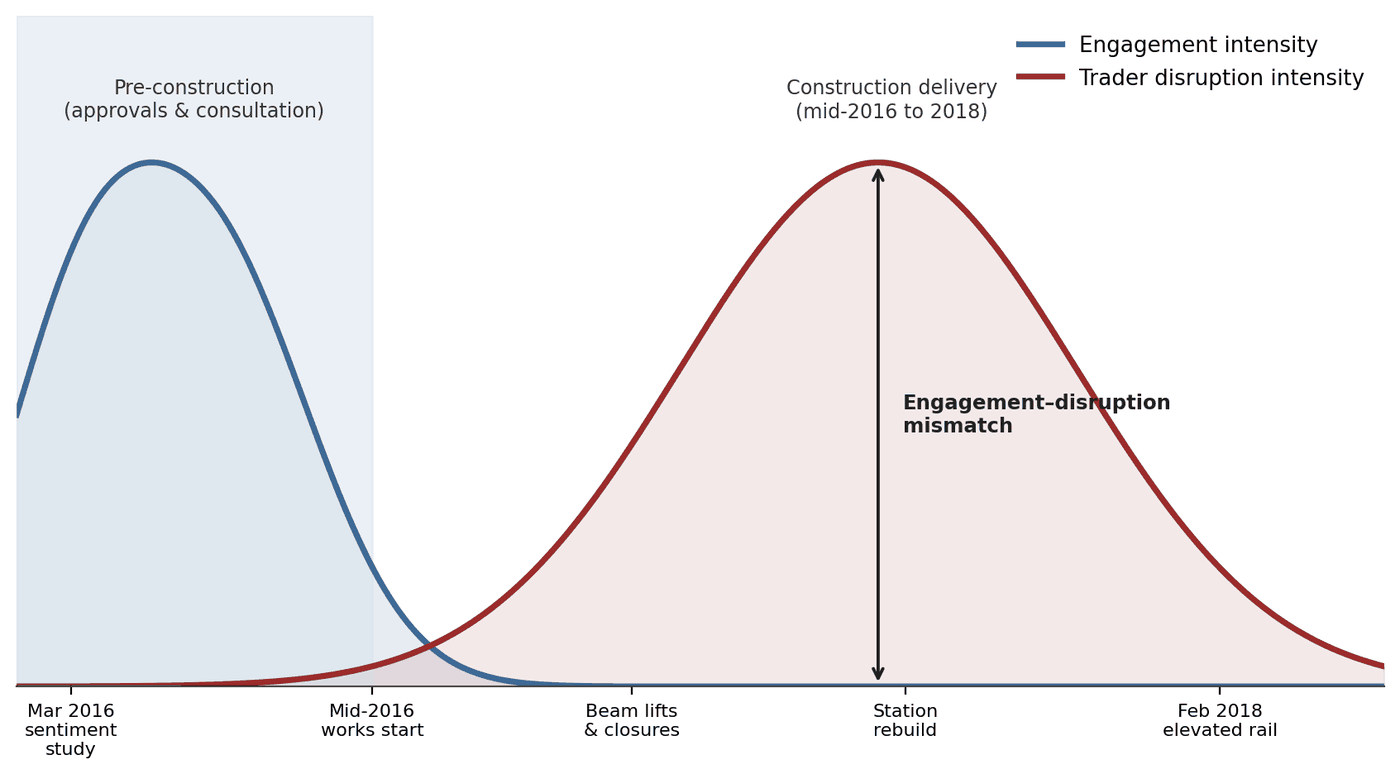

Found four linked weaknesses: high engagement activity but only 17% pre-construction awareness among rail users, engagement front-loaded before construction and weakest during the disruption itself (Fig. 3.2), no measurement of commercial impact on traders, and the people accountable for community outcomes had no say over construction decisions. The clearest evidence of what was left unresolved: a $3.5M trader revitalisation package committed three years after completion. We delivered five recommendations, including an outcome-oriented evaluation framework and a unified cross-agency Community Outcomes Director role.

Why it matters

Engagement is easy to measure by activity count and easy to get wrong that way. I know how to separate genuine influence on decisions from documentation of decisions already made, and to turn that gap into recommendations a delivery authority could actually implement.

Next case / 04 Model, Unmodel, Remodel A board-level appraisal, and the error I caught in my own first pass
CASE / 04

Model, Unmodel, Remodel

My roleSole author: model, appraisal and risk assessment
TeamTwo linked individual reports
Timeline2025, project finance and project risk subjects
TypeMaster's coursework, treated as a client engagement
13.68%
Project return (IRR)
Between the 12.46% and 13.85% hurdles
-$1.16M
Value at the return shareholders need
+$9.15M at the lower rate
79%
Chance the project loses value
At a glance

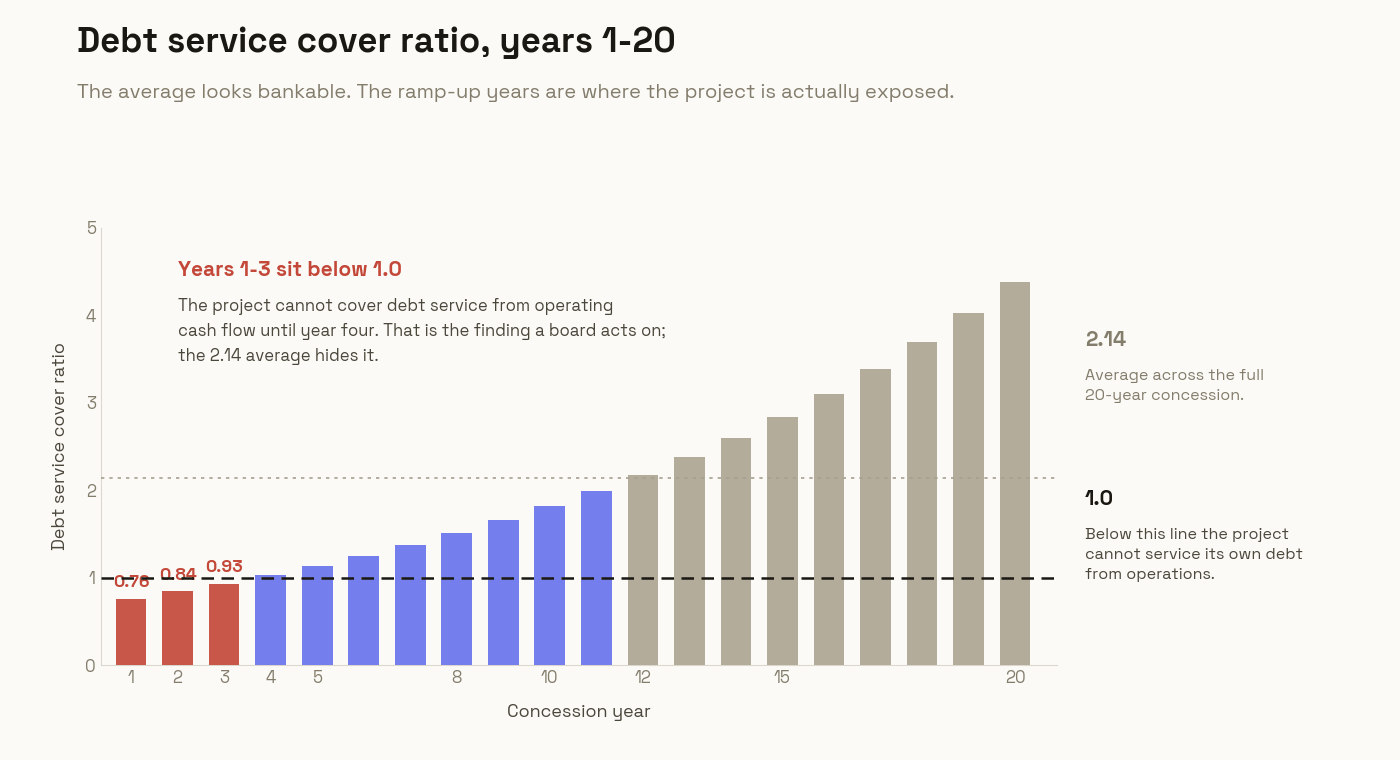

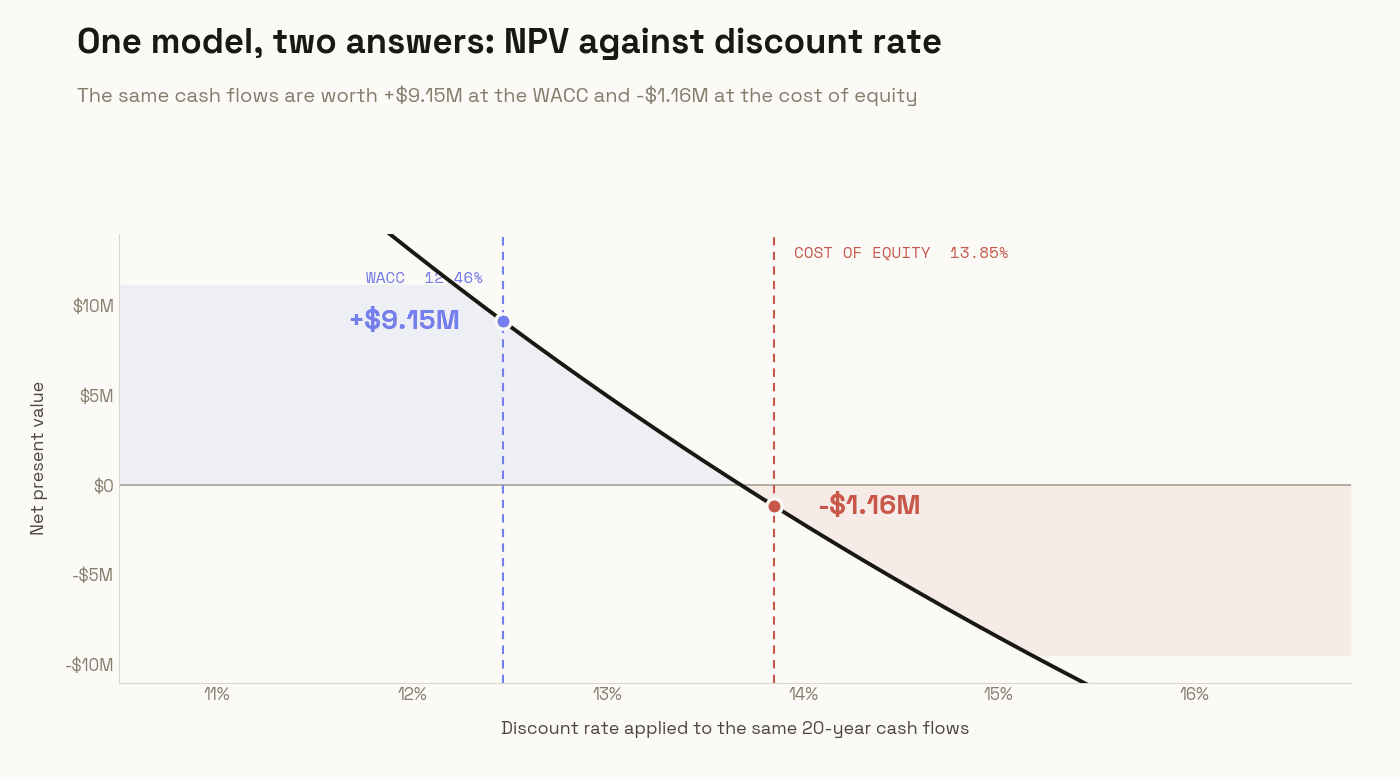

Net present value of the project against the discount rate applied The same curve with the 1.39-point band between WACC and cost of equity highlighted FIG. 4.1Interactive The project's 13.68% return falls between its blended cost of finance (12.46%) and the return shareholders need (13.85%), so whether it creates or destroys value depends on which rate you use.
Context

Two linked reports to the board of a company weighing a 20-year deal to build a water-treatment plant, run it, then hand it over. It would cost $85M to build, funded 75% by loans at 12% and 25% by shareholders, with income locked in through three long-term supply contracts.

What I did

I built the full 20-year financial model in Excel, then wrote a second report whose job was to pull it apart. That second pass caught that my first report had judged the project against the wrong rate of return. I corrected it, re-checked year by year whether the plant could cover its loan repayments, ran 10,000 simulated scenarios on revenue and costs, and paired each major risk with a specific safeguard.

Result

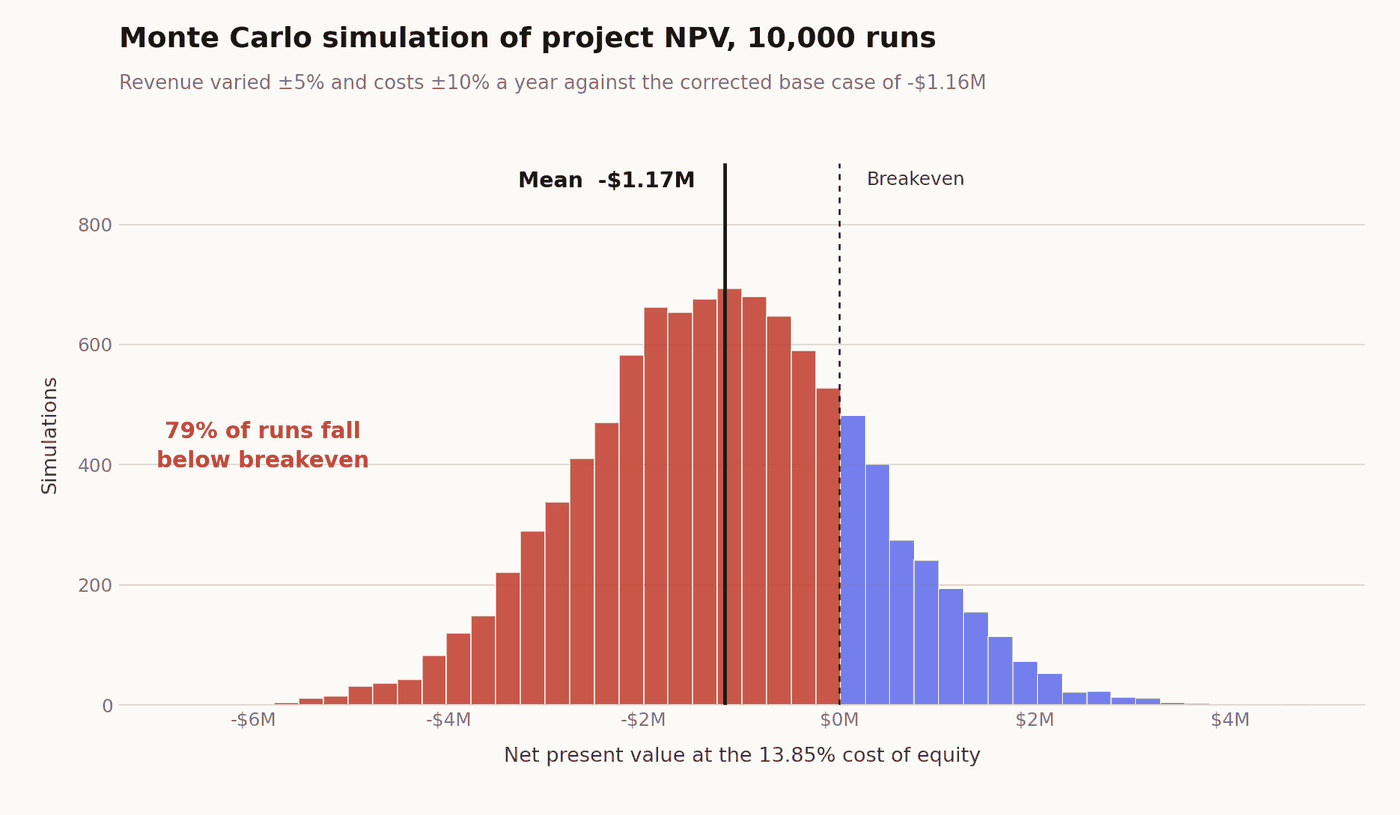

The project's 13.68% return lands between the two rates it could fairly be judged against, so the answer flips: worth +$9.15M at the blended cost of finance, -$1.16M against what shareholders need (Fig. 4.1). In 79% of simulated scenarios it lost value (Fig. 4.3). The sharper finding was cash: for its first three years the plant can't earn enough to cover its loan repayments (Fig. 4.2). I recommended going ahead only with repayments shaped to match the plant's income and a cash reserve to cover the early shortfall.

Why it matters

A business case isn't finished when the numbers look positive. It's finished when someone has gone back hard enough to find what the first pass got wrong, and said so. That's what I'd bring to an investment paper.

Next case / 05 Structure without control: the myki governance gap Where documented risk stopped short of becoming a binding decision
CASE / 05

Structure without control: the myki governance gap

My roleSole author of the individual report. In the group work: the investment logic map and the international comparison
TeamIndividual report, alongside a four-person group presentation (Group 1)
TimelineSemester 1, 2026, public sector project management
TypeMaster's coursework, treated as a client engagement
$136.8M
Cost increase
From an 18-month delay
6
Government agencies compared
2012 → 2028
Tap-and-go gap
London 2012, Sydney 2017, Melbourne 2028
At a glance
Context

An individual report comparing how well Australian government agencies run projects at federal, state and local level, alongside a group project on why Melbourne's upgrade of myki to tap-and-go bank card payments fell years behind London and Sydney.

What I did

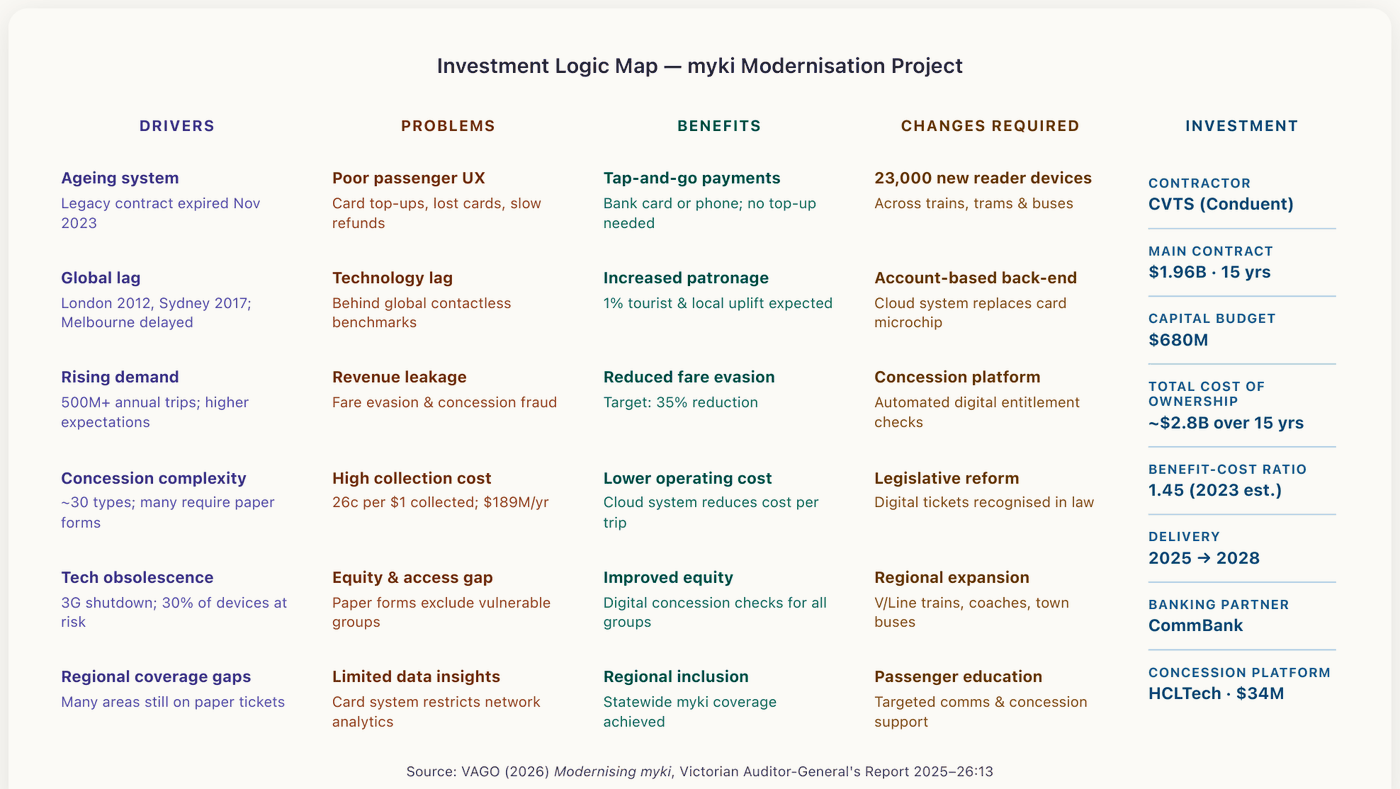

I rated six agencies against a standard project-management maturity scale, two at each level of government (for example, the Tax Office and the National Disability Insurance Agency federally). For the group, I built the investment logic map for the myki contract (Fig. 5.1), and the international comparison behind the London, Sydney and Melbourne timeline.

Result

Victoria's transport department ran a sound tender, but signed the contract with known schedule risks still unresolved. The result was an 18-month standstill and a $136.8M cost increase. The technology wasn't the problem; London and Sydney had already proven it. The failure was governance: the risks were written down, but never turned into a decision before signing.

Why it matters

This is the check I'd bring to a project office: don't sign off on an optimistic schedule, and know how to find the exact point where process stopped giving real control.

Next case / 06 Failing at failing: How Not to Control a Project Tracing each symptom back to the control that was missing
CASE / 06

Failing at failing: How Not to Control a Project

My roleSole author
TeamIndividual consultancy report
Timeline2025 - ~2,870 words
TypeMaster's coursework, treated as a client engagement
6
Areas of project management diagnosed
$17M
Expansion, no feasibility study
0
Formal scope baseline or close-out
At a glance
Context

A ~2,870-word consultancy management report on the Woody 2010 case: a custom woodworking company's $17M capacity expansion that collapsed into cost overruns, schedule slippage, and unresolved supplier disputes.

What I did

I used the industry-standard project management framework (PMBOK) to check six areas: who had authority, stakeholder communication, scope, cost, schedule and close-out. I traced each failure back to the control that was missing and paired it with a fix (Fig. 6.1): a written scope with a formal process for approving changes, a plan for who hears what and when, tracking of progress against budget, and a close-out checklist.

Result

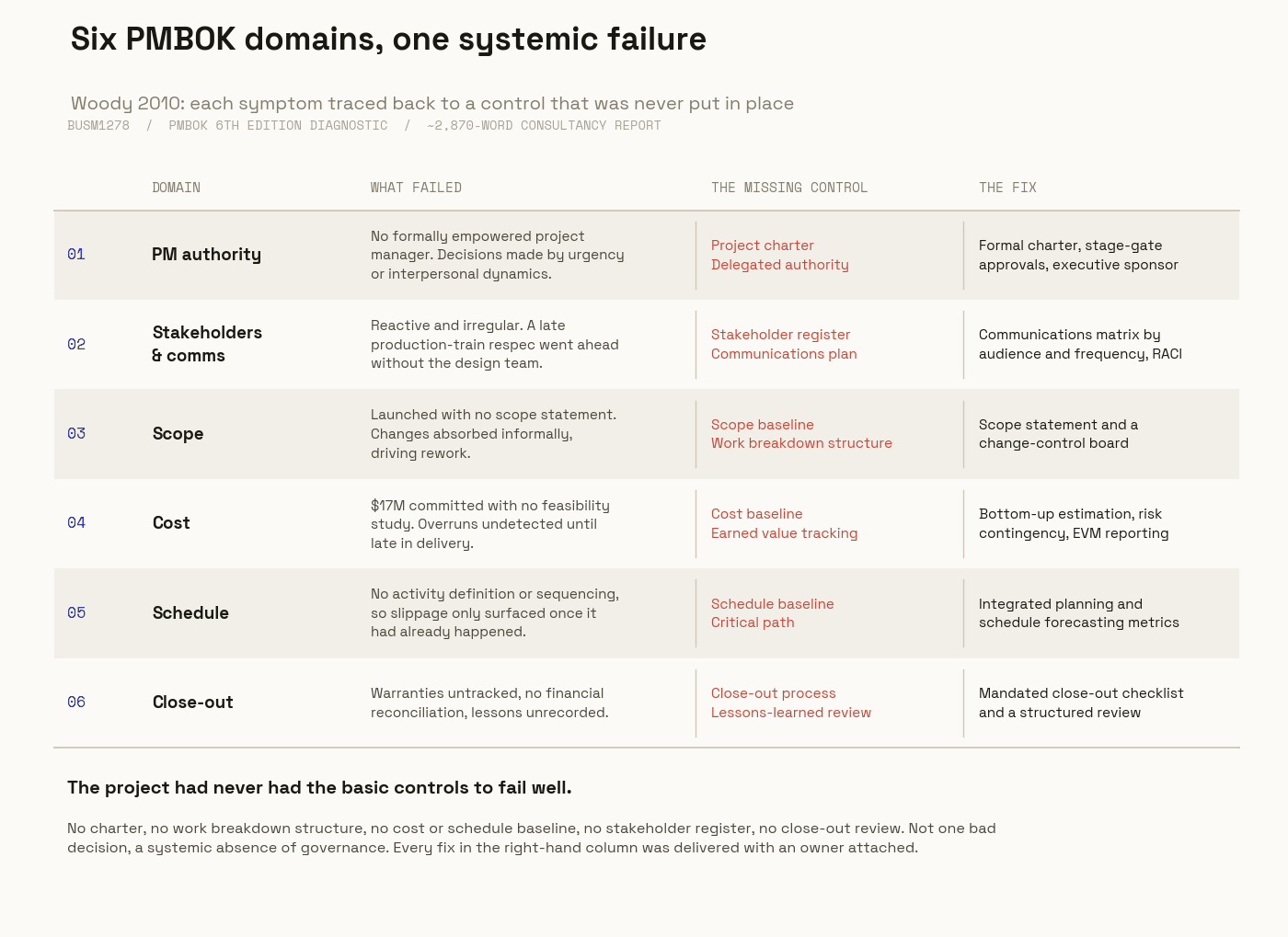

The project hadn't failed from one bad decision; it had never had the basic controls to fail well: no charter, no work breakdown structure, no cost or schedule baseline, no stakeholder register, no close-out review. I delivered a full set of recommendations to rebuild those controls before the next capital project, not after the next failure.

Why it matters

This is the PMBOK toolkit applied end to end rather than module by module. It's the same lens I'd use to diagnose a struggling program: work backward from the symptom to the missing control, and give the fix an owner.

Next case / 07 Netflix - Workflows... and Sometimes It Doesn't Find the bottleneck first, then pick the framework
CASE / 07

Netflix - Workflows... and Sometimes It Doesn't

My roleTeam leader; value-stream and bottleneck analysis, TO-BE workflow design
TeamFour-person group I led, BUSM4764
TimelineSemester 1, 2026
TypeMaster's coursework, treated as a client engagement
3
Root causes isolated
$9.2B
Content-in-production assets
Scrum + Kanban
Recommended model
At a glance
Context

A group project for BUSM4764 (Agile Project Management), applying Agile and Lean to Netflix's in-house content production, where fragmented, stage-based workflows across creative, production and tech teams were driving delayed releases, missed audience trends, and higher cost and rework.

What I did

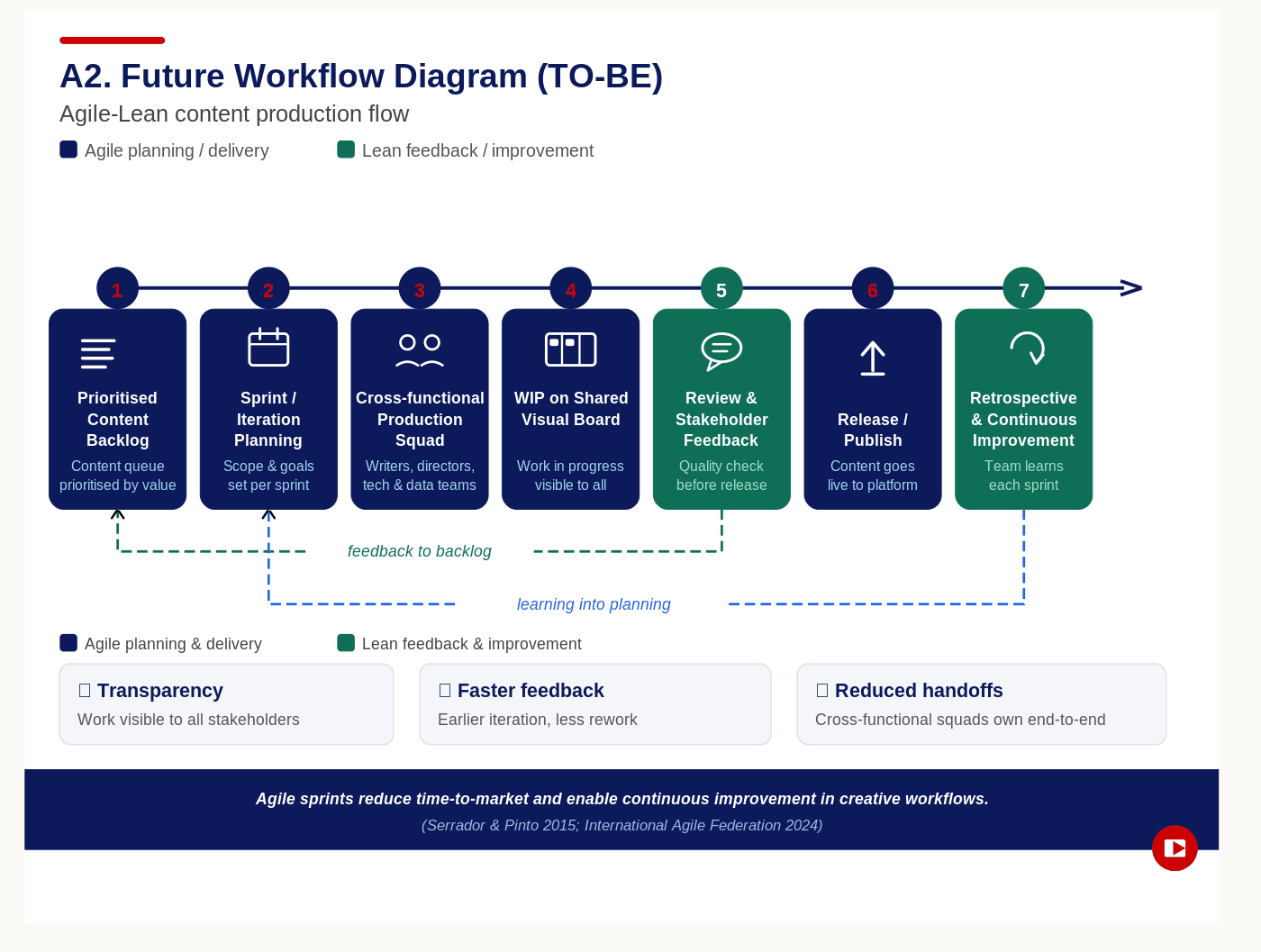

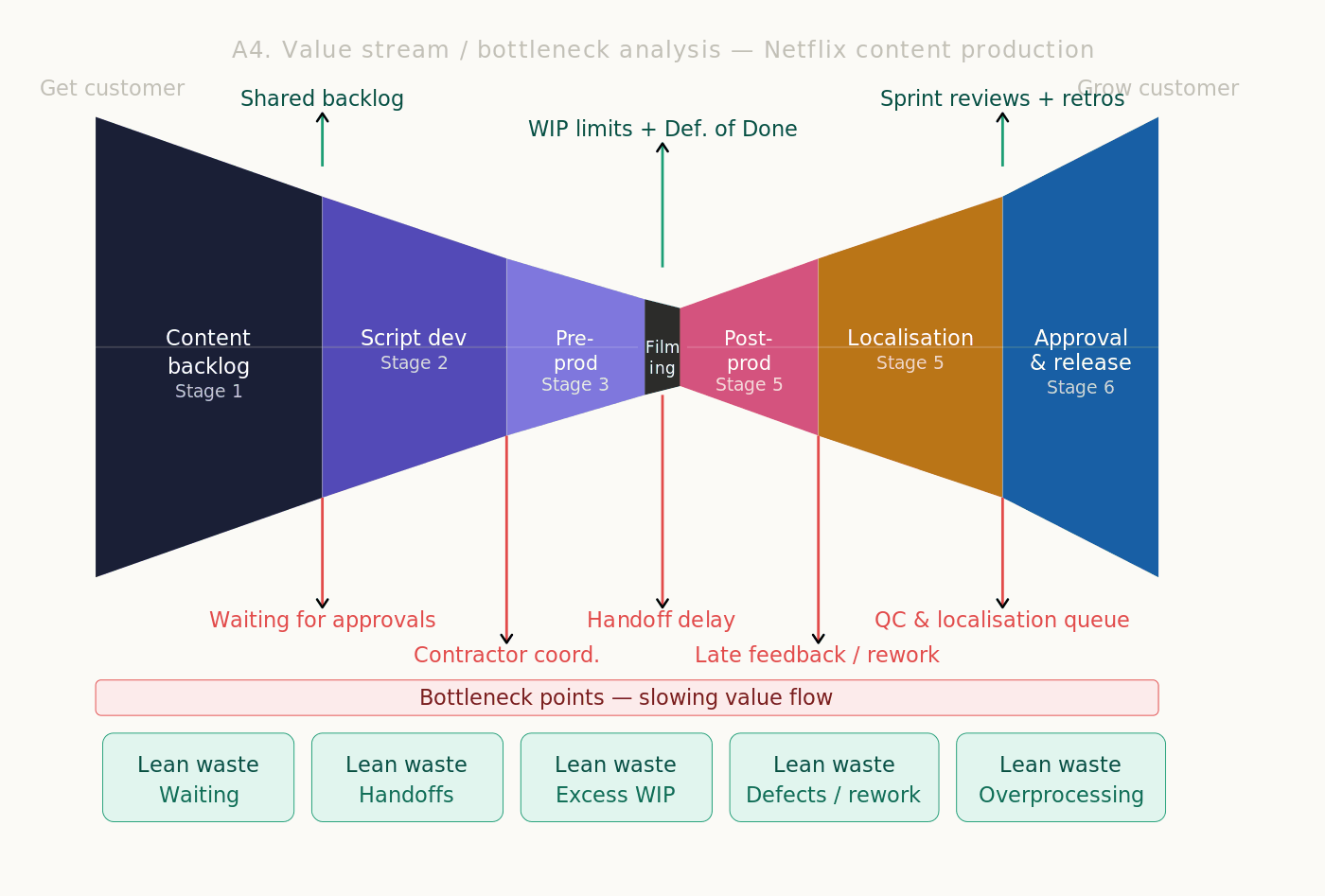

Used value-stream mapping and root-cause and bottleneck analysis to locate where the fragmentation actually lived (Fig. 7.1): sequential handoffs, low visibility and reactive late-stage decisions. I then designed the fix (Fig. 7.2): a shared Scrum cadence across creative, production and tech with regular reviews to surface issues earlier, supported by Lean and Kanban for waste elimination and real-time flow visibility.

Result

A staged implementation roadmap: pilot one production team, establish sprints and retrospectives, bring external studios into shared visibility, then scale across content divisions. Success is measured on flow, delivery and collaboration metrics rather than on whether teams were simply "doing Agile." Backed by the ICAgile Certified Professional (ICP) certification I earned in the course.

Why it matters

A delivery methodology only earns its place if it's chosen for the bottleneck it fixes, not applied by default. This is that instinct: find the actual constraint first, then match the framework to it.

More write-ups in progress.
